Reinstatement Cost Singapore (2026): Why One Quote Is $5K and Another Is $8K
Not all reinstatement quotes cover the same scope of work. Find out what affects pricing, what hidden costs to watch for, and how to choose the right contractor.
Key Takeaways
- Reinstatement costs typically range from S$8 to S$30+ per square foot
- Retail, F&B, warehouse, and factory spaces usually cost more to reinstate than offices
- Hidden costs such as disposal fees, permit applications, and PE endorsement can increase the final project cost
- Start planning your reinstatement at least 2-3 months before lease expiry to avoid delays and handover penalties
Your lease is ending, and you need to return your 800 sqft office to its original condition before handing it back to the landlord.
One contractor quotes $5,000. Another quotes $8,000. Now you're left wondering which quotation is actually reasonable. Are you being overcharged, or has the cheaper contractor missed something?
Reinstatement costs can vary significantly, even between offices of a similar size. A quotation doesn't just depend on the floor area. It also depends on what's installed inside the unit and what's required before handover.
In this guide, we'll look at typical reinstatement costs in Singapore, what affects the final price, and how to tell whether a quotation is reasonable before making a decision.
How Much Does Reinstatement Cost in Singapore
Reinstatement costs in Singapore typically range from S$8 to S$30+ per square foot. However, most reinstatement projects are priced based on the type of premises and scope of work involved rather than floor area alone.

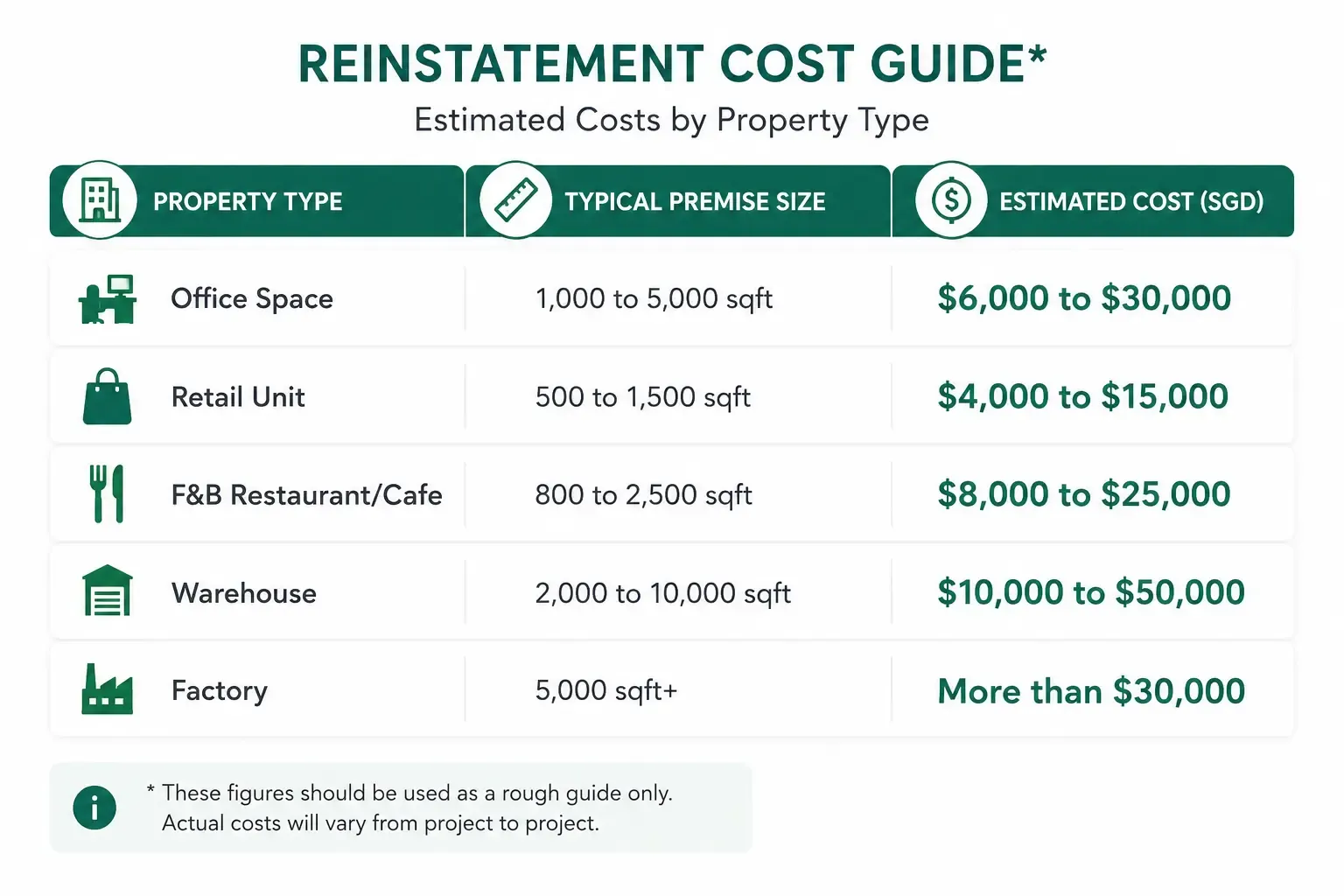

Reinstatement Cost by Property Type
Office
Office spaces typically range from 1,000 to 5,000 sqft and cost between S$6,000 and S$30,000 to reinstate.
These projects are generally more straightforward and typically involve partition removal, flooring removal, repainting, and the removal of electrical and data points.
Retail
Retail spaces typically range from 300 to 1,500 sqft and cost between S$2,000 and S$15,000 to reinstate.
Costs are often driven by custom carpentry, display fixtures, signage, specialised lighting, and shopfront modifications.
F&B
F&B outlets typically range from 800 to 2,500 sqft and cost between S$8,000 and S$25,000 to reinstate.
Kitchen equipment, exhaust ducts, grease traps, gas pipes, and plumbing systems often need to be dismantled and removed before handover.
Warehouse / Light Industrial
Warehouse and light industrial premises typically range from 2,000 to 10,000 sqft and cost between S$10,000 and S$50,000 to reinstate.
Storage racks, mezzanines, loading bay modifications, and electrical installations can significantly affect the final cost. For JTC properties, tenant-installed racking systems may also need to be removed before handover.
Factory / Heavy Industrial
Factory and heavy industrial premises are typically larger than 5,000 sqft and often cost S$30,000 or more to reinstate.
Machinery removal, production lines, machinery foundations, utility systems, and demolition works can all have a significant impact on cost. In many cases, the cost is driven more by the equipment being removed than the size of the space itself.
What Hidden Costs Should You Look Out For
When comparing reinstatement quotations, don't just look at the final figure.
One contractor may include disposal, permit applications, and restoration works in their quotation. Another may not.
That's why the cheapest quotation isn't always the cheapest project. Costs that weren't included in the original quotation can quickly surface once work begins.
Disposal Fees
Reinstatement projects often generate a large amount of waste, including partitions, flooring, carpentry, signage, machinery, and renovation debris.
If disposal costs aren't included in the quotation, they can quickly add up. This is especially common for warehouses, factories, and larger commercial spaces where more materials need to be removed from site.
What to do: Confirm whether disposal and transport costs are included before accepting the quotation.
Building Management and Permit Fees
Some buildings require permits, deposits, after-hours work arrangements, or supervision fees before reinstatement works can begin.
These costs are not always included in the quotation. Depending on the building's requirements, they may need to be settled before works can proceed.
What to do: Check with your landlord or building management early and ask your contractor to clarify which fees are included.
Additional Demolition and Rectification Works
Not all existing conditions are visible during the initial site survey.
Hidden cabling, additional flooring layers, or tenant-installed structures may only be discovered after work begins. When this happens, additional demolition or restoration works may be required.
What to do: Engage a contractor that conducts a thorough site survey and clearly explains any assumptions made in the quotation.
Multiple Contractors & Subcontracted Work
Some reinstatement contractors outsource parts of the project to third-party subcontractors.
While subcontracting is common in the industry, it can create additional layers between you and the people carrying out the work. This may lead to communication gaps, delays, or additional costs when unexpected issues arise during the project.
What to do: Ask whether the works will be carried out by the contractor's own team or outsourced to third-party subcontractors.
PE Endorsement
Certain reinstatement projects may require a Professional Engineer (PE) endorsement, particularly where structural elements such as mezzanines, machinery foundations, or structural modifications are involved.
What to do: Ask whether your contractor can advise on PE requirements and coordinate the endorsement process if needed.
Our team can assess whether PE endorsement may be required and guide you through the necessary inspections and documentation. For more information, read our guide on PE Endorsement Singapore: What It Is and When You Need It (2026).
Why Choose Yi Hui Metals
Like any tenant, the last thing you want is for reinstatement works to drag on, causing you to miss your handover date and risk penalties or deductions from your security deposit.
With over 19 years of industry experience, we've completed reinstatement projects across offices, retail spaces, factories, warehouses, and JTC properties. As a BCA-registered contractor backed by trained site specialists, our team can spot potential issues early, from disposal requirements and permit applications to PE endorsement and restoration works, helping you avoid unexpected costs and delays.
Need help with your reinstatement project? Contact us today for a site assessment and quotation.

You might also like

Returning a Factory in Singapore? What You Need to Know (2026)
Preparing to return a factory? Find out what reinstatement works are typically required, how long they take, and what to expect before handover.

PE Endorsement Singapore: What It Is and When You Need It (2026)
Unsure if your reinstatement works require PE endorsement? Learn when it's needed, how it's arranged, and what to expect before work begins.

Returning a JTC Property? Here's What You Need to Know (2026)
Returning a JTC property? Learn what needs to be removed, how the reinstatement process works, and what to expect before handing your property back.
Speak With Us
Got something to clear, dispose of, or reinstate? Drop us a message and we'll get back to you within 1 to 2 business days.
Yi Hui Metals
23 Tuas South Street 1, Singapore 638033
